DAR AL NOOR EXPANSION | PHASE 1 SITE WORK
Construction Update - October 2026
Status as of November 4, 2026 | Community Website Update
Alhamdulillah, we are pleased to share meaningful progress on Phase 1 of the Dar Al Noor expansion. Much of the work right now is below ground, but it is essential to preparing the future parking area and drainage system. After a long period of plan-review and site-condition challenges, our crews have been moving forward with earthwork and preparations for the next installations.
Site work: 984 truckloads removed
Between October 13 and October 29, our site team removed 984 truckloads of unsuitable soil and construction debris. The material contained significant clay and could not be reused where properly compacted fill is required. Removing it has freed up space and allowed the team to keep preparing the site for the next steps.
On November 4, the existing security shed was demolished, clearing a separate obstruction to grading. Rough grading is now underway. Our site supervisor is continuing to coordinate with the soil inspector before deciding whether any additional excavation is necessary, so we do not remove material unnecessarily.
An unexpected cost we want to share openly
The unsuitable-soil removal was not anticipated in the original Phase 1 budget. The 984 truckloads cost $265,020 to remove, averaging approximately $269 per load. This was an unplanned and unbudgeted expense, and we are continuing to assess any remaining soil work carefully before committing to additional hauling or fill.
Stormwater materials and November work
Most of the underground storm chambers and related stormwater structures have been delivered and are already on site. Five units remain outstanding. The next planned steps are to receive and lay concrete pipe, install available storm structures, and then place the storm chambers as each work area is ready.
These are upcoming activities, not completed installations. Progress will depend on weather, the remaining materials, soil-inspector direction, required inspections, and confirmation of approved field layouts and civil-plan conditions.
Schedule and funding

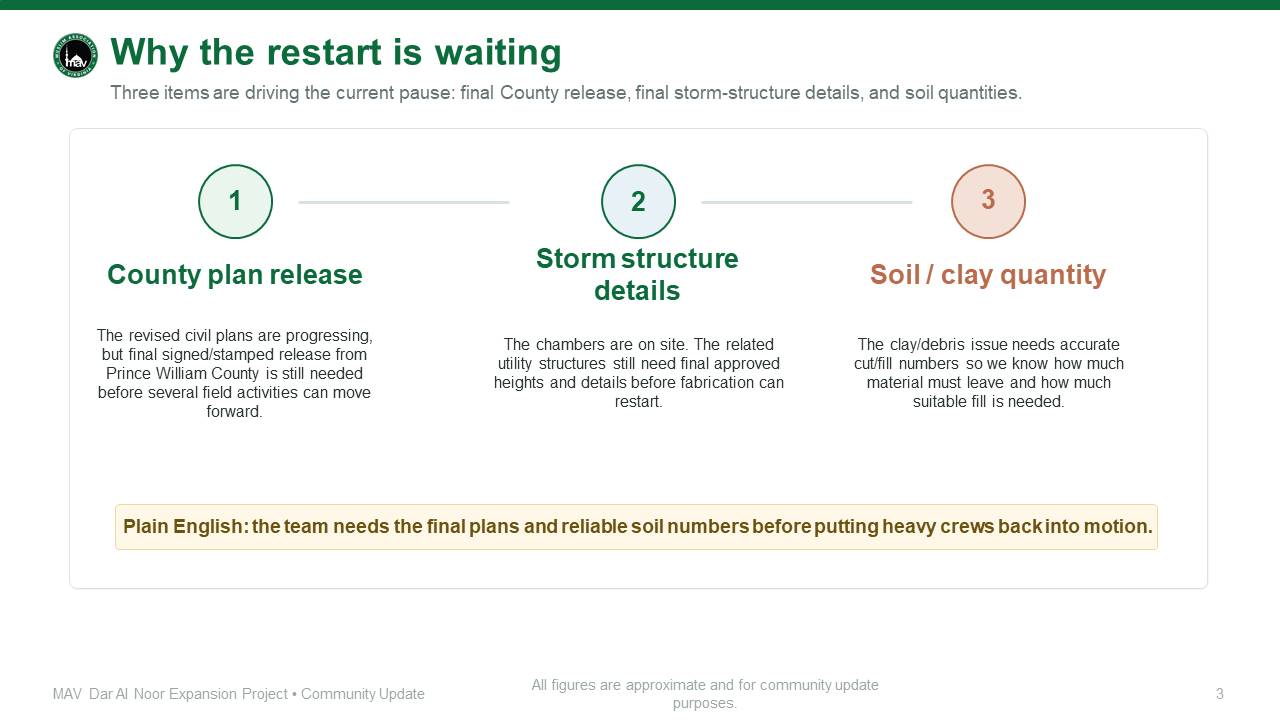

We have made important progress, but the previously shared December 2 site-completion target is no longer a reliable commitment. The Construction Committee and field team are working through the remaining sequence and will share a revised target once the required work and delivery dates are better defined.
For financial transparency, $271,520 in additional project payments has been reported since the previous monthly Board update: $265,020 for the unbudgeted soil removal and $6,500 for site supervision. Based on the previous community funding estimate, and adjusting only for these payments, the illustrative totals are approximately $4.375 million raised, $2.255 million spent, and $2.120 million cash on hand. These are planning estimates, not Treasurer-certified balances, and assume no other transactions during the period.
Thank you for your patience and support
We appreciate the community's patience as we work through the conditions that come with a site-development project of this size. Our priority is to move forward carefully, safeguard community contributions, and keep everyone informed as milestones are completed, insha'Allah.
Please continue to avoid the construction and material storage areas, and keep children away from equipment, soil piles, and work zones. JazakumAllahu khairan for your continued support and duas.
October 2026 Community Update PDF
7 pages

MAV / Dar Al Noor Expansion • Phase 1 Site Development October 2026 | 1 MUSLIM ASSOCIATION OF VIRGINIA Dar Al Noor Expansion PHASE 1 • SITE WORK UPDATE October 2026 Current through November 4, 2026 The work beneath the future parking lot is moving forward. CURRENT SITE AERIAL Replace this area with a current site aerial photo Aerial overview of current Phase 1 site conditions

A lot of ground has been covered What was completed in October - and what is happening now MAV / Dar Al Noor Expansion • Phase 1 Site Development October 2026 | 2 984 truckloads removed Unsuitable clay and mixed debris hauled off site between October 13 and October 29. NOV 4 Security shed demolished NOW Rough grading is underway Remaining excavation will be guided by the soil inspector. AERIAL: EARTHWORK & GRADING Replace this area with a current site aerial photo Aerial photo: cleared and graded site, taken after October 29

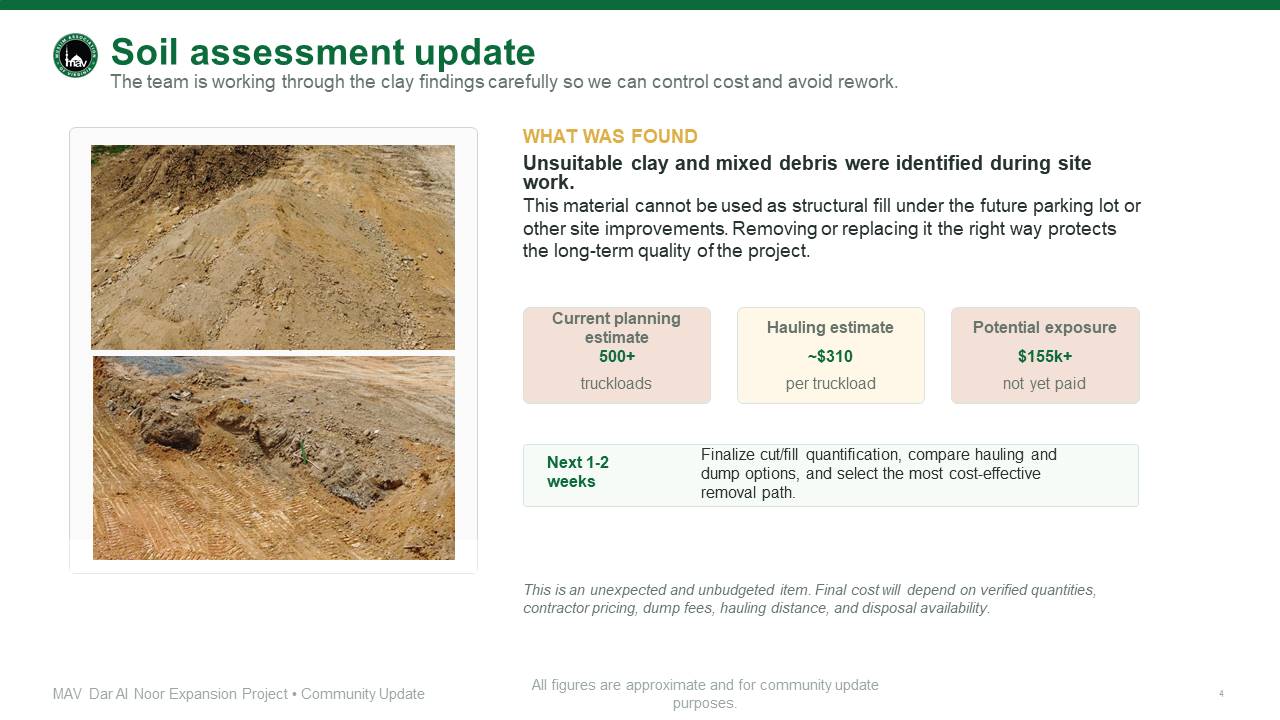

The soil was a bigger job than expected Why the additional work was necessary MAV / Dar Al Noor Expansion • Phase 1 Site Development October 2026 | 3 What we found Areas of high-clay soil and mixed construction debris. The unsuitable material could not be reused as structural fill. We removed 984 loads and are checking whether any additional excavation is needed. UNEXPECTED / UNBUDGETED $265,020 paid for soil/debris removal ~$269 per load What comes next Inspector guidance will help avoid unnecessary further hauling and cost.

Getting ready for the underground drainage system Most of the stormwater materials are already on site MAV / Dar Al Noor Expansion • Phase 1 Site Development October 2026 | 4 Materials & readiness MOST ON SITE Storm chambers and related structures 5 UNITS Still expected to complete the inventory NEXT Concrete pipe receiving and utility layout coordination Planned installation order 01 Trench & place concrete pipe 02 Install available storm structures 03 Install storm chambers Sequence depends on approved layout, inspections, weather and material deliveries.

Funding status An updated view of what has been reported MAV / Dar Al Noor Expansion • Phase 1 Site Development October 2026 | 5 Funds raised* ~$4.375M Spent to date* ~$2.255M Cash on hand* ~$2.120M Newly reported spending since the prior Board update $265,020 Unbudgeted unsuitable-soil removal $6,500 Site supervision ADDITIONAL PAYMENTS $271,520 *Illustrative totals derived from the previous community estimate, adjusted only for these reported payments. Actual donations, balances and all other activity remain subject to Treasurer confirmation. Jan 2011 - Sept 2026 through current update

What we are working on next November priorities, in the order the site can safely support them MAV / Dar Al Noor Expansion • Phase 1 Site Development October 2026 | 6 01 Keep rough grading moving Follow the soil inspector’s guidance on any remaining excavation and fill. 02 Begin underground utility work Confirm pipe deliveries, layout and trench readiness before placement. 03 Set storm structures, then chambers Install available units as field conditions, inspections and deliveries allow. Timing update: A revised completion date is still being developed. AERIAL: CURRENT WORK AREA Replace this area with a current site aerial photo Aerial photo: current grading and planned stormwater area

MAV / Dar Al Noor Expansion • Phase 1 Site Development October 2026 | 7 Thank you for helping move Dar Al Noor forward. JazakumAllahu khairan for your patience, prayers and continued support. Please keep construction areas clear for the safety of families, staff and contractors. Follow the next update We will share confirmed milestones as installation and grading progress. Support the Expansion daralnoor.org/donate MAV Administration & Construction Committee
